P3 Procurement Accelerates 558 Bridge Replacements in Pennsylvania

P3 Procurement Accelerates 558 Bridge Replacements in Pennsylvania
​Pennsylvania Department of Transportation ​Pennsylvania, USA
​CDM Smith provided technical advisory services to the Pennsylvania Department of Transportation (PennDOT) to develop this award-winning P3 procurement.
A Strategic Solution to Accelerate Safety and Mobility
Inside just 3 years—by the end of 2017—an unprece­dented 558 bridges had been replaced across Penn­syl­va­nia, improving safety and mobility for travelers thanks to a ground­break­ing public-private partnership (P3) between the Penn­syl­va­nia Department of Trans­porta­tion (PennDOT) and developer consortium Plenary Walsh Keystone Partners (PWKP). The Rapid Bridge Replacement (RBR) project originated in 2013, when PennDOT was challenged by an aging, struc­turally deficient (SD) bridge inventory and limited funding and resources. The department sought a cost-effective, efficient solution to replace hundreds of its roughly 4,000 SD bridges, while minimizing public incon­ve­nience and overcoming its funding and resource shortfalls. CDM Smith provided technical advisory services to PennDOT to identify bridges for program inclusion and to develop a strong P3 procurement.

Screening for Best-fit Bridges

PennDOT Key 1Given the state’s significant number of SD bridges, a two-tiered screening process was deployed to identify which bridges were the best fit for the project. First, high-level criteria were applied to identify single and two-span SD bridges that required full replacement, were repre­sen­ta­tive of PennDOT’s portfolio, and did not have active consultant activity. This brought the eligible bridge total to around 900. Next, bridges were assessed based on 35 detailed criteria, including P3 readiness, envi­ron­men­tal concerns, remaining life, cost to replace, volume of traffic, and number of lanes. By the end of the assessment, the final list narrowed to 558 bridges.

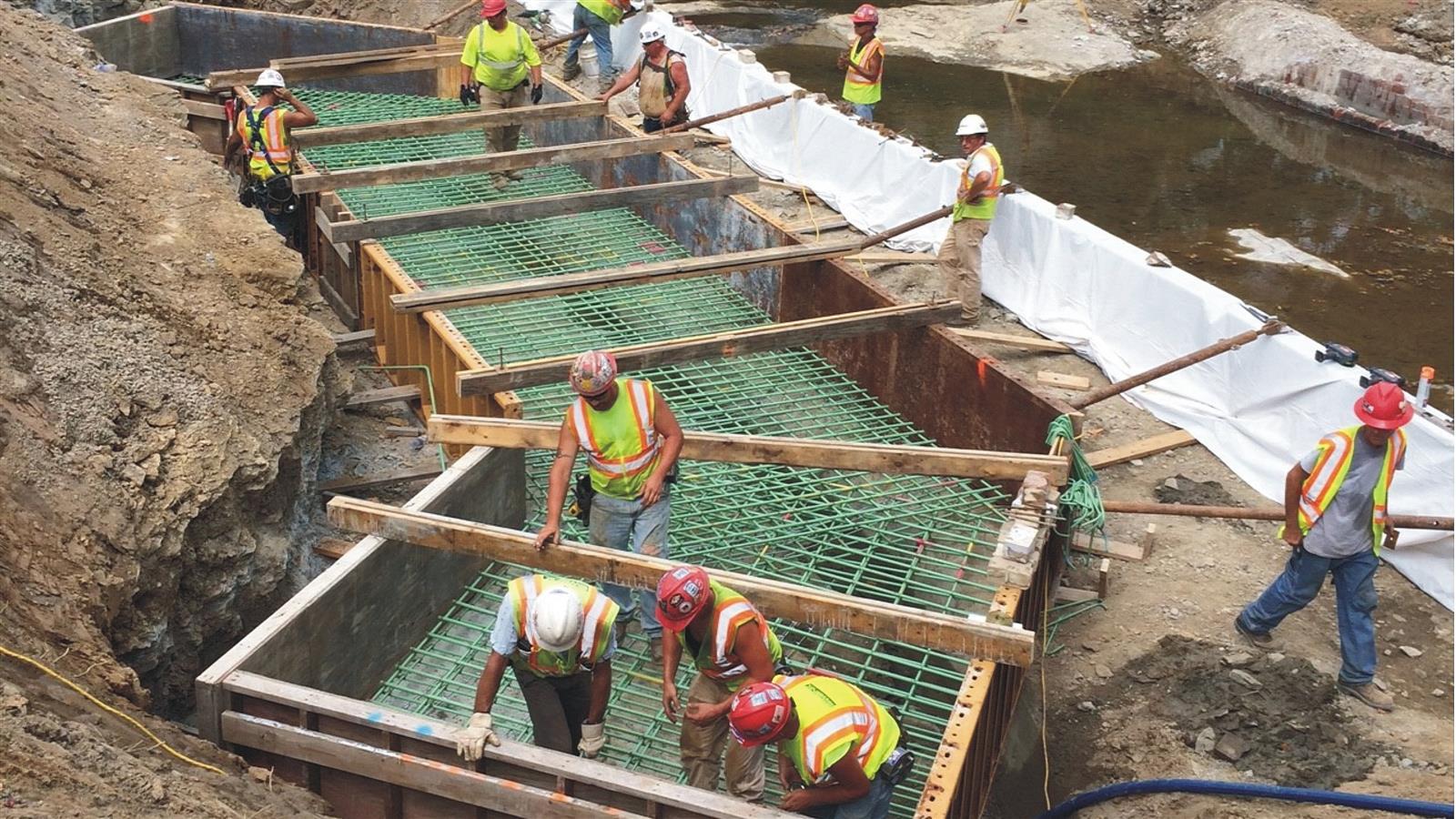

Enabling Assembly-Line Design and Construc­tion

PennDOT Key 2With the right bridges identified, CDM Smith and PennDOT then devised a procurement that aimed to drive innovation in logistics and supply chain management. A set of technical require­ments was developed to allow for pre-design of a number of standard bridge designs, enabling assembly line production of bridge components and lowering unit costs and delivery times. The similarity of the SD bridges selected during the screening facilitated streamlined design and prefab­ri­ca­tion of stan­dard­ized components, and it also enabled rapid replacement to be possible.

The 558 SD bridges were scheduled to be replaced ... decades sooner [due to the] strong agreement between PennDOT and its private-sector partners.

Putting Replace­ments on the Fast Track
PennDOT Key 3For PennDOT, it was important that the developer begin construc­tion on a number of bridge replace­ments in the contract’s first year. Before
construc­tion could begin, each replacement had to first be designed and receive necessary envi­ron­men­tal permits and approvals. To expedite construc­tion activities so multiple bridges could be ready for construc­tion during year one, the concept of “early completion bridges” (ECBs) and “remaining eligible bridges” (REBs) was included in the procurement. While PennDOT agreed to advance the envi­ron­men­tal, right-of-way, and utility clearances for the designated 88 ECBs, PWKP took respon­si­bil­ity for obtaining all clearances for the REBs.

Divvying up Maintenance in Phases
PennDOT Key 4For P3 projects that include a maintenance component, the developer is typically responsible for all maintenance for the duration of the contract. With 558 small bridge sites across the state, such an arrangement would have been very costly and not in PennDOT’s best interest. So CDM Smith and the department formed an approach that allocated maintenance respon­si­bil­i­ties to the party best positioned to perform each activity and gave PennDOT sufficient time to assume maintenance respon­si­bil­i­ties. Under this approach, PWKP adheres to phased handback require­ments: vegetation is handed back 1 year after a bridge’s completion, flexible pavement after 5 years, and all remaining elements after 25 years.

Procuring Success and Accolades
The RBR contract was procured, awarded in 12 months to PWKP, and financially closed in March 2015. As a result of the innovative screening process and procurement approach, and the P3’s single avail­abil­ity payment concession agreement, many firsts were achieved: PennDOT’s first trans­porta­tion P3, the nation’s first allocation of private activity bonds, and the first project to receive the Federal Highway Admin­is­tra­tion’s “Special Exper­i­men­tal Project 15” approval. This ground­break­ing, nationally recognized project has gone on to win three awards: Best Transport Project at P3 Awards 2015, one of the Public Works Financing’s top 10 Transport Deals of the Year, and an ACEC/PA’s 2016 Honor Award for Engineering Excellence.

The project achieved substantial completion on January 2, 2019 with all 558 poor condition bridges being replaced. The majority were replaced in an expedited timeframe with minimal impacts to the traveling public and PennDOT’s traditional highway and bridge delivery program.

John Munoz John Munoz
Not only were we able to deliver high quality bridges, we were also cost effective through the process, which we knew was important to PennDOT.
